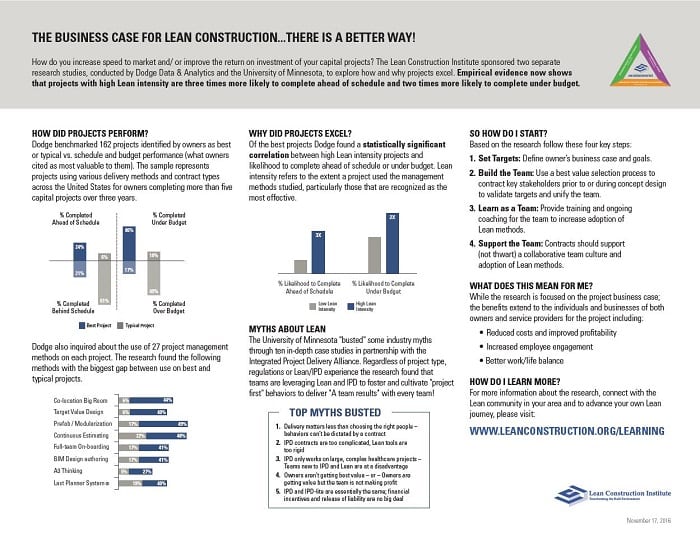

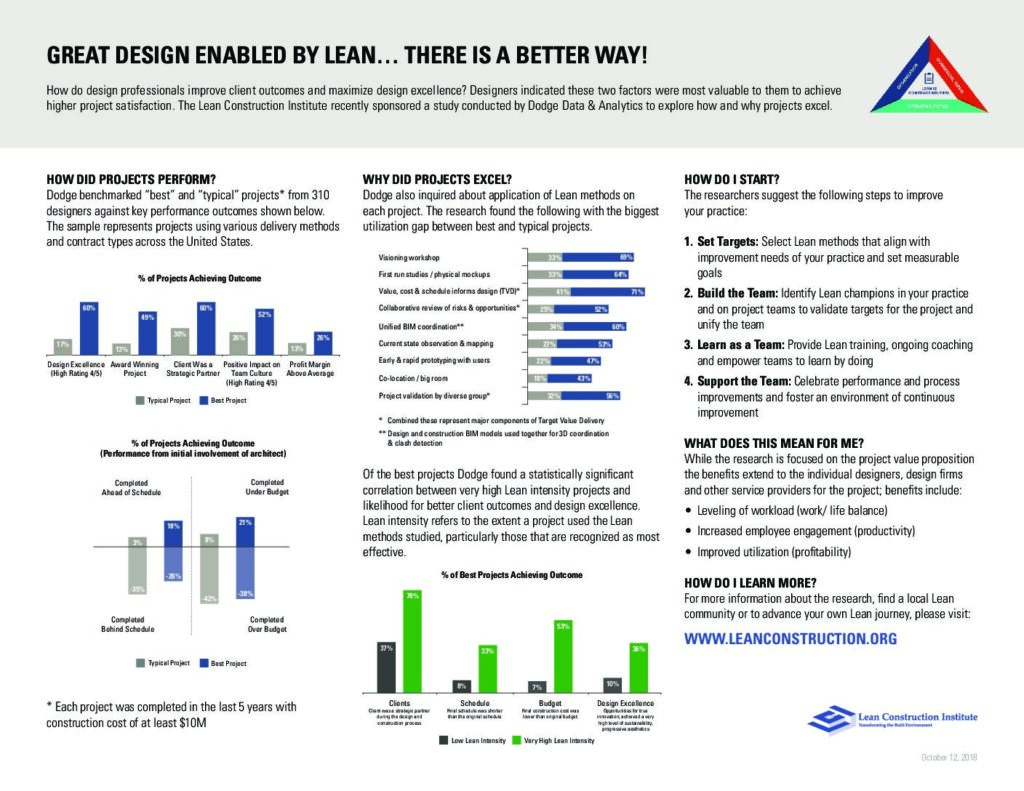

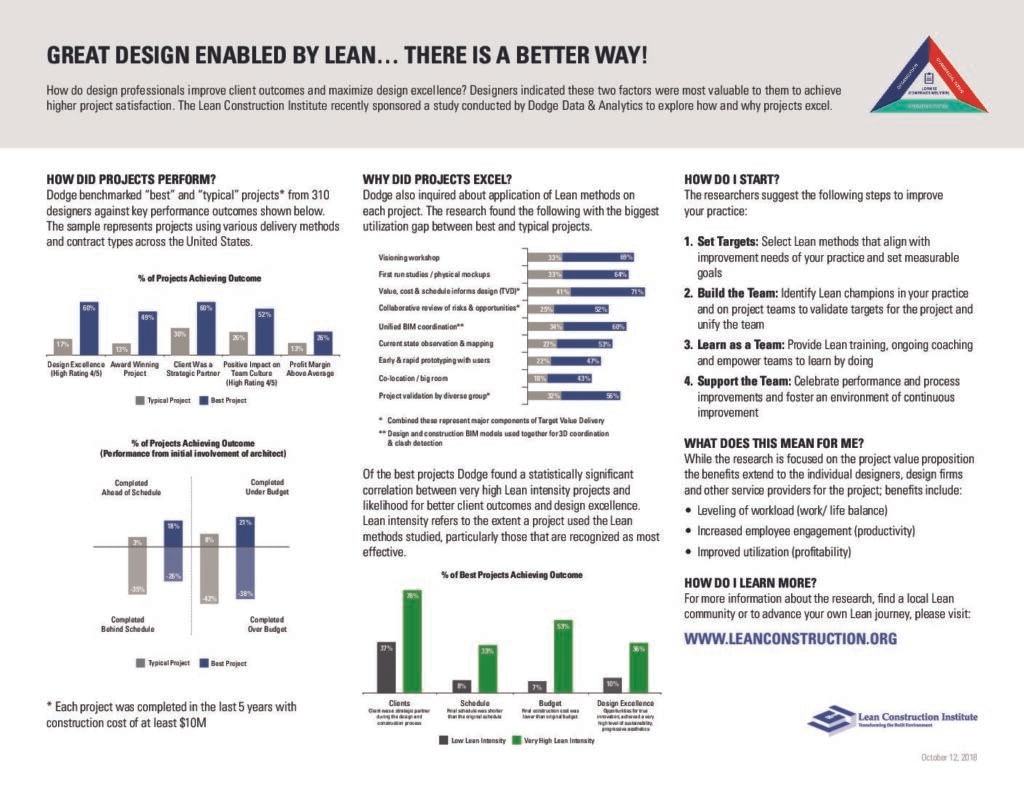

How do you increase speed to market and/ or improve the return on investment of your capital projects? The Lean Construction Institute sponsored two separate research studies, conducted by Dodge Data & Analytics and the University of Minnesota, to explore how and why projects excel. Empirical evidence now shows that projects with high Lean intensity are three times more likely to complete ahead of schedule and two times more likely to complete under budget.
With data center demand projected to rise 10% each year until 2030, more flexible and resilient build-outs are becoming increasingly important to compete in this fast-evolving industry. ...
